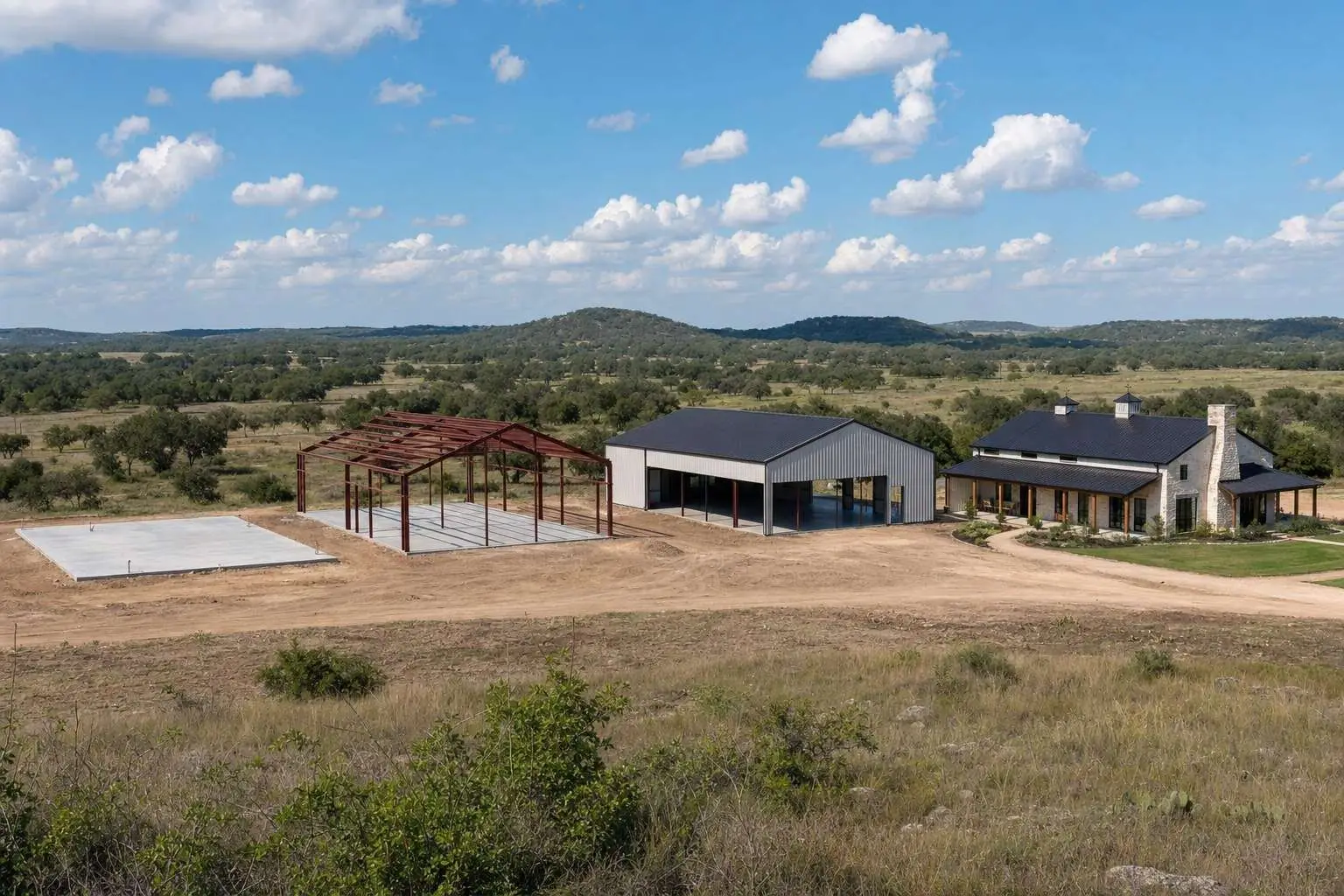

A standard 2,400 sq ft barndominium in Central Texas takes 5 to 7 months from groundbreaking to move-in in 2026, including site prep (3-4 weeks), foundation cure (3-4 weeks), steel frame and shell (3-4 weeks), and interior buildout (10-14 weeks). Custom designs, weather delays, and permit issues can extend this to 8-11 months.
“How long until we can move in?” is the second question every barndominium client asks us, right after price. The honest answer for a standard Central Texas build is 5 to 7 months — but the path to that number is more interesting than the number itself. This post walks through every phase, what causes delays, and what you can do to keep your build on schedule.
Standard Timeline: Month-by-Month
| Phase | Duration | What Happens |
|---|---|---|
| Pre-construction | 4–8 weeks | Design finalization, contract, permits, deposits |
| Site prep | 2–4 weeks | Clearing, grading, utility rough-ins |
| Foundation | 2–4 weeks | Forms, rebar, slab pour, cure |
| Steel frame | 1–2 weeks | Red-iron erection, secondary framing |
| Shell complete | 2–3 weeks | Roof, siding, windows, doors |
| Rough-ins | 3–4 weeks | Electrical, plumbing, HVAC |
| Insulation + drywall | 3–4 weeks | Spray foam, hang, tape, finish |
| Interior finish | 5–7 weeks | Cabinets, countertops, flooring, paint |
| Final trades + punch list | 2–3 weeks | Finish electric, plumbing, HVAC, inspections |
Add it up: roughly 24–35 weeks of active construction, or 5–8 months. Most well-managed builds in Central Texas hit the 5–7 month range.
Phase 1: Pre-Construction (4–8 Weeks Before Groundbreaking)
This is the phase clients consistently underestimate. Before any excavator touches dirt, we need:
- Final architectural plans and engineering stamps
- Signed fixed-price contract with detailed allowances
- Permits (septic, electrical, floodplain, and city permits if applicable — see our county-by-county permit guide)
- Materials ordered (steel frame lead times are typically 6–10 weeks)
- Survey, soil test, and utility locates
The best thing a client can do during pre-construction is finalize selections early. Cabinets, countertops, flooring, fixtures, paint colors — picking these in month one rather than month four prevents costly mid-build delays.
Phase 2: Site Prep (Weeks 1–4)
Once permits are in hand and materials are ordered, site work begins. This includes:
- Clearing and grubbing (mesquite removal, brush clearing)
- Building the pad — compacted base for the slab
- Trenching for utilities (water, electric, septic field)
- Driveway approach and any culvert installation
- Well drilling, if applicable (timing varies — book early)
- Septic installation, if applicable
Wet weather is the biggest threat in this phase. A heavy spring rain in McLennan, Hill, or Limestone County can shut down site work for two weeks while soil dries.
Phase 3: Foundation (Weeks 3–6)
Once the pad is built, the foundation crew sets forms, places rebar, runs under-slab plumbing, and pours the slab. Central Texas’s expansive clay soils typically require an engineered slab with post-tension cables or thickened edge sections. The pour itself takes a single day; the cure is 21–28 days before the steel frame can be erected.
Phase 4: Steel Frame + Shell (Weeks 7–11)
This is the most visible and most satisfying phase. The red-iron steel frame erects in 3–5 days. Secondary framing (girts and purlins) adds another 3–5 days. Then the roof and exterior siding go up — typically 5–10 days for a 2,400 sq ft build. Windows and exterior doors arrive and install in this window. By the end of this phase, your barndominium is “dried in” — weatherproof shell complete.
Phase 5: Rough-Ins (Weeks 10–14)
Electrical, plumbing, and HVAC crews work simultaneously inside the shell. This phase ends with a series of municipal or county inspections (depending on jurisdiction) before drywall can go up. Inspection delays are the most common cause of mid-build slowdowns.
Phase 6: Insulation and Drywall (Weeks 14–18)
Closed-cell spray foam goes on the underside of the roof deck and the inside of exterior walls. After the foam cures (24–48 hours), the drywall crew hangs, tapes, floats, and textures the interior. This is typically a 3–4 week phase.
Phase 7: Interior Finish (Weeks 18–25)
The longest single phase. Sequence matters:
- Interior paint (primer + two coats)
- Flooring (tile in wet areas first, then hardwood or LVP)
- Cabinets and countertops
- Backsplash tile
- Finish plumbing (fixtures, toilets, sinks)
- Finish electric (light fixtures, switches, outlets, ceiling fans)
- Interior doors and trim
- Appliances
Phase 8: Punch List and Final Inspections (Weeks 25–28)
The final two to three weeks involve final inspections, the punch list walkthrough (every nick, scratch, missing piece of trim), and ultimately the certificate of occupancy. Some clients move in immediately; others wait until after closing on construction-to-permanent financing.
What Causes Delays
Weather (the most common)
Wet spring weather in Central Texas can push the schedule by 2–6 weeks. The foundation and site-prep phases are most vulnerable. Steel frame erection requires dry ground for the crane.
Permit and inspection delays
Builds inside Waco, Temple, College Station, or other city limits face inspection backlogs that can add 1–4 weeks of cumulative delay. Builds in unincorporated rural counties have minimal inspection delays.
Client decision delays
The most common controllable delay. Late cabinet selections, repeated finish changes, or slow approval of variance requests can each push the schedule by weeks. Lock selections early.
Materials and supply chain
2026 has been the most stable supply environment in five years, but some specialty items (custom windows, imported tile, designer fixtures) still carry 8–14 week lead times. Order early.
Lender draw schedule mismatches
Construction-to-permanent loans release funds in 4–6 phased “draws” tied to completed milestones. If a draw inspection runs late, work pauses while the bank’s inspector visits. The CFPB has good background on construction loan mechanics.
What You Can Do to Stay on Schedule
- Finalize design before contract. Changing the design after groundbreaking is expensive and slow.
- Pick all finishes before month two. Cabinets, flooring, fixtures, paint, tile — every selection.
- Start your loan paperwork early. Even before plans are final.
- Visit the site weekly, not daily. Frequent client visits with new ideas cause delays.
- Use one decision-maker. If the contract has two clients, agree in advance on who has final say on selections.
- Trust your builder’s schedule. The general contractor sequences trades for a reason; out-of-order requests cascade.
Build Times by Project Type
| Project | Standard Timeline |
|---|---|
| 1,200 sq ft (30×40) barndominium | 4–6 months |
| 2,400 sq ft (40×60) barndominium | 5–7 months |
| 3,000+ sq ft custom barndominium | 7–9 months |
| Barndominium + attached shop | 6–8 months |
| Steel shop building (no living space) | 2–3 months |
| Four-stall horse barn | 2–3 months |
| Covered roping arena (60×120) | 3–4 months |
Frequently Asked Questions
What’s the fastest a barndominium can be built in Texas?
The fastest realistic timeline for a 2,400 sq ft turnkey barndominium is about 4.5 months, assuming perfect weather, fast permits, in-stock materials, and a client who locks selections in week one. Most builds land at 5–7 months.
Can you build a barndominium in winter in Texas?
Yes — Central Texas winters are mild enough that construction continues year-round. Concrete pours below 40°F require additives. Hard freezes are rare south of Hillsboro.
Why does steel framing build faster than wood?
Pre-engineered steel arrives on site as a kit. A 40×60 frame erects in 3–5 days. The equivalent wood frame takes 2–3 weeks of stick-by-stick work plus weather dependencies.
How long does the foundation take to cure?
A typical residential slab cures to 75% of design strength in 7 days and full design strength in 28 days. We typically wait 21 days minimum before erecting the steel frame.
Do I need to be on site during construction?
No. We coordinate everything and send weekly photo updates. A walkthrough at frame completion and another at drywall completion is plenty for most clients.
Get a Schedule for Your Project
Every quote we send includes a phase-by-phase schedule tailored to your design, your site, and your county. Request a consultation and we’ll walk you through the realistic build window for your specific project. For more on what we build, see our main services page
